Appendix 1
BIM Case Study: One Island East

Introduction

One Island East is the name of a 70-storey, Grade A, commercial building located at North Point on Hong Kong Island. Completed in 2008, it is one of the first commercial buildings that was designed and constructed using building information modelling (BIM) including virtual construction. The adoption of these technologies enabled improvements in quality and significant savings in time and cost. The adoption of these technologies changed design and construction organisation and processes. Using BIM for the production of this building has formed the basis for efficient facilities management. One Island East comprises one of the most substantial BIM implementations for a commercial building. The building was awarded the American Institute of Architects’ 2008 BIM Award for design delivery and process innovation. This appendix outlines the production of the model and then focuses on the use of the model for planning and scheduling the construction work.

Building the model

The BIM for One Island East was produced using Gehry Technologies Digital ProjectĀ® software which is based on Dassault SystĆØmesĀ® software. It comprises two main products: CATIAĀ® (for product modelling) and DEMIAĀ® (for process modelling). CATIAĀ® enables integration and interoperability with Microsoft ProjectĀ® and PrimaveraĀ® planning and scheduling software.
The project had already reached the completion of the schematic stage of design when it was decided to adopt BIM for the detailed design stage onwards. Modelling was undertaken on the basis of a single 3D BIM project database. All the elements of the building were modelled by the creation of rule-based parametric object data including the comprehensive modelling of the mechanical, electrical and plumbing systems.
The BIM model was used to facilitate the detailed design of the building, the drawing production, design coordination and cost implication of design decisions. To do this, it was necessary to manage the design team and manage the design model.
Gehry Technologies were awarded the contract for managing the design process and the production of the BIM model. The Architect (Wong and Ouyang (HK) Ltd), the Structural Engineer (Ove Arup and Partners (HK) Ltd), M&E consultants (Meinhardt (M&E) Ltd) and the Quantity Surveyors (Levett and Bailey) formed the key members of the design team. In addition to staff in these organisations’ head offices, it was decided to co-locate design team members in a single project design office close to the construction site. Here, between 25 and 50 designers worked collaboratively on the design. Key to ensuring fast construction was clash detection and resolution before construction commenced. The design team using the BIM model resolved a total of more than 2000 clashes and design errors prior to tendering. The completeness of the BIM model based on the building elements and the components enabled accurate cost estimates to be prepared and maintained whenever design changes were made.

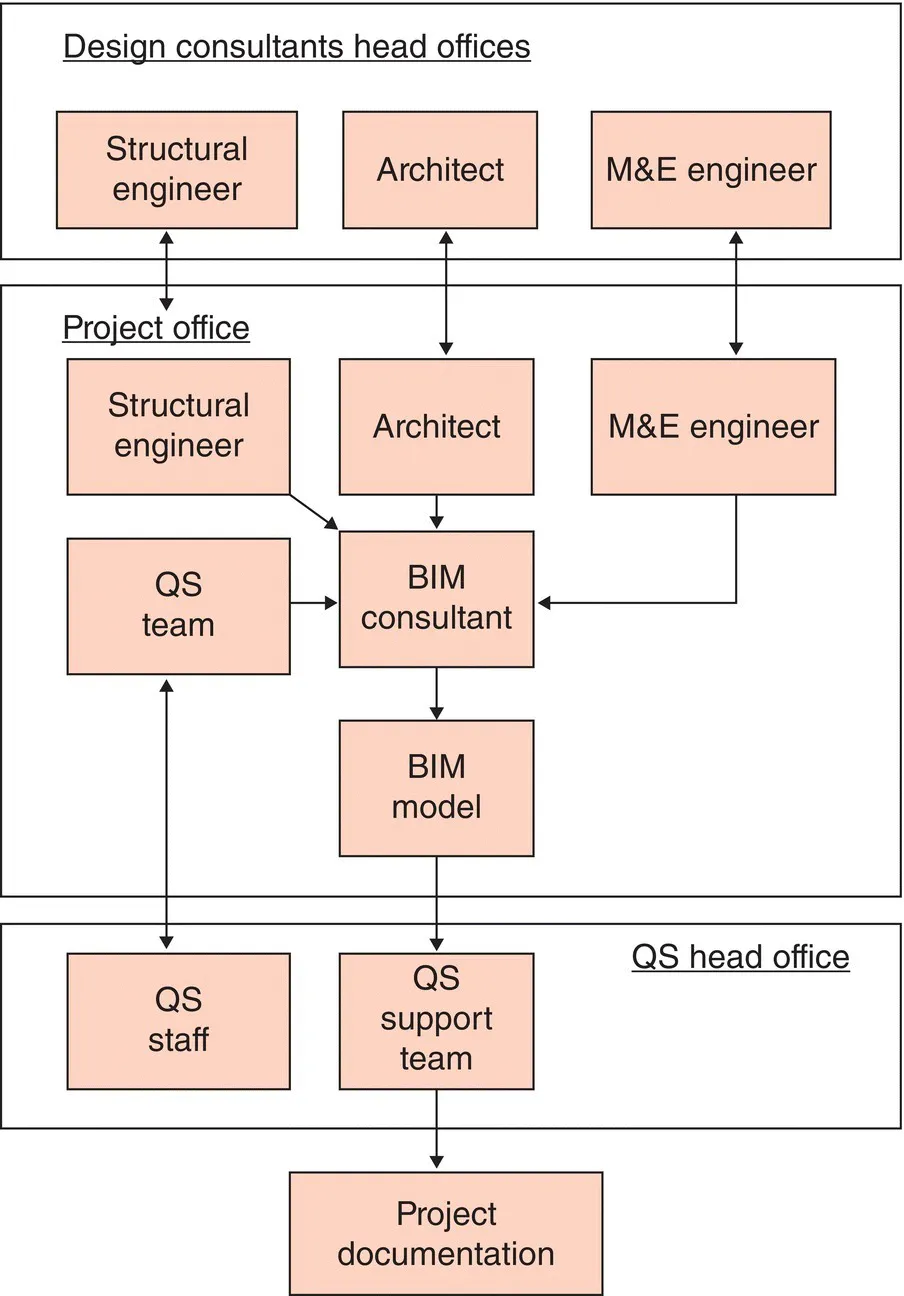

Figure A1.1 shows a schematic diagram of the organisation of the design team.
a1-fig-0001
ā€ƒ
Figure A1.1 A schematic diagram of the design team.

The tendering process

The contract for the construction of the building was awarded following a selective tendering process. As part of this process, all the construction companies who tendered for the work were required to prepare a simulation model of how they proposed to undertake the construction process. To do this, they were provided with a copy of the BIM model and assistance with training on how to extract and use the data. Additional training and guidance was provided by BIM experts at Hong Kong Polytechnic University, HKPU.
The successful contractor (Gammon Construction) was required under the contract to take responsibility for the BIM, to maintain the model during the construction process and to hand over the updated model with the completed building, thus ensuring that on completion the client (Swire Properties) was in possession of a comprehensive, accurate model of the building that could be used for facilities management.
At the time of tendering, the data contained in all the main building elements were complete together with their main attributes: size, volume, weight, etc. Tendering was therefore on the basis of precise quantities. The BIM tool enabled many of the quantities to be measured automatically. There was no need for the contractors to measure the quantities of work. (However, the building model did not include all the reinforcing steel bars in the structural elements. For accuracy, the contractors bidding decided to calculate the quantity and price of the reinforcement in the structure manually using the ratio of reinforcement to concrete for individual elements.)
Using the model, Gammon were able to analyse the construction process and be confident that a four-day construction cycle could be achieved. The detail in the model enabled accurate cost estimates to be prepared.

Modelling the building process: Planning, scheduling and visualisation

During the construction of the building, the building model generated virtual construction models that became the central management tool for the production process, identifying construction problems and assisting the construction team to identify and solve construction problems before they impacted production on-site.
The BIM elements became a key part of the process of determining the construction sequence. (An example of this was the re-fabrication of the floor table formwork across the stages of construction where the outriggers changed the profile of the building.)
The visualisation and demonstration of construction sequences to the construction team (including subcontractor gangs of workers) enabled all concerned to contribute to ensuring the optimum construction process. The use of visualisation enabled production to be examined from a number of different aspects, for example, spatial requirements when moving temporary works and site safety, ensuring a fast safe production schedule.
The integration of Primavera scheduling software with Digital Project enabled planning engineers to link the BIM components to the activities in the Primavera construction model and produce updated schedules and 4D simulations of the construction sequence. (This integration was achieved by incorporating Primavera activity data in the building model ā€˜tree structure’.)
This integration was two-way, enabling modelling staff to import project (and sub-project) data, work breakdown structures and construction activities from Primavera into the Digital Project modelling environment. The impact of changes in the construction schedule on the building product could therefore be assessed.
This way of working ensured that construction proceeded to schedule. Gammon estimate that the use of the visualisation saved 20 days off the construction schedule. (The building was completed in March 2008 ahead of the 24-month construction schedule.) It is estimated that there was a 20% saving on the cost of construction.

Appendix 2
The Shepherd Way and Collaborative Planning

Shepherd Construction have reviewed the principles and methods of Last PlannerĀ® and Lean Construction to produce a ā€˜company-wide’ approach to Collaborative Planning. This is a four-stage process involving the whole construction ā€˜team’ who work together to create and agree a ā€˜lean’ production schedule, identify risks to production performance and agree an implement solutions. They work to deliver the agreed schedule by identifying and removing constraints, producing weekly plans and measuring and monitoring performance against the agreed schedule. Examination of performance and investigation as to what has gone well and where problems have arisen identifies issues and areas for improvement throughout the programme.

Collaborative Planning

The Shepherd Way requires the team to establish a schedule collaboratively. This is a schedule that is agreed by all; it is a stable schedule, one fixed by a ā€˜team’ comprising representatives from all the trades involved. Working collaboratively, uncertainty is removed. The agreed way of working seeks to fully utilise the team’s skills and experience. Opportunities for improved ways of working and increased production are explored, incorporated in the way of working or disregarded. Potential risks are evaluated and measures taken to mitigate the risk. Production issues are examined together with common interface problems. Forward planning identifies mobilisation needs and ensures that production may commence when anticipated.

Collaborative behaviours

Collaborative working require...
